Precision Tube Journal verifies what North America's tube industry can actually make.

Reducing scrap in ERW tube production

Scrap is a physical loss and a process signal. A single total-scrap number hides whether the plant is losing material during startup, steady production, cutoff, dimensional control, welding, surface handling, documentation, or customer containment.

Originally published in the ASTM A513 handbook (astma513.com), where specification-scoped A513 reference material remains.

Code the loss consistently, identify the first process stage where it became detectable, preserve the product/material/tooling/setup state, and confirm that corrective action reduces verified loss without weakening containment or quality controls.

Define the loss before improving it

Use more than one measure:

  • Weight
  • Length
  • Pieces
  • Material value
  • Conversion value already added
  • Lost production time
  • Rework time
  • Containment and sorting cost
  • Customer or delivery impact

One measure can distort priority. A short length of high-value processed material may cost more than a larger weight of startup trim.

Use a controlled reason hierarchy

Start with broad categories that can be assigned reliably:

  1. Planned startup, shutdown, trim, and sample
  2. Material identity or incoming condition
  3. Entry and forming
  4. Fin and edge preparation
  5. Weld and scarf
  6. Cooling, sizing, reshape, and straightening
  7. Cutoff and length
  8. Surface and handling
  9. Dimensional or test nonconformance
  10. Documentation, traceability, or certification
  11. Maintenance or equipment event
  12. Other/unknown — with mandatory investigation above a defined threshold
Field Example
Loss stage Weld and scarf
Observed symptom Intermittent seam opening
Verified cause Cause unconfirmed pending edge and process review
Containment Coil and time boundary segregated
Final cause Entered only after evidence confirms it

A loss record with separate symptom and verified-cause fields (example)

Add a second field for the observed symptom and a third for verified cause. Do not use a cause code when only the symptom is known. This prevents the database from treating assumptions as history.

Find the first detectable stage

If finished tube is out of dimension, move upstream and determine where the dimension or its precursor first departs from the controlled progression. If a surface mark appears after sizing, identify whether the same clock-position evidence exists before sizing. If a seam split is discovered at cutoff, review edge condition, fin exit, welded condition, heat/pressure/speed, cooling, and fracture evidence.

The defect diagnostic guide on this site provides the full process-order workflow.

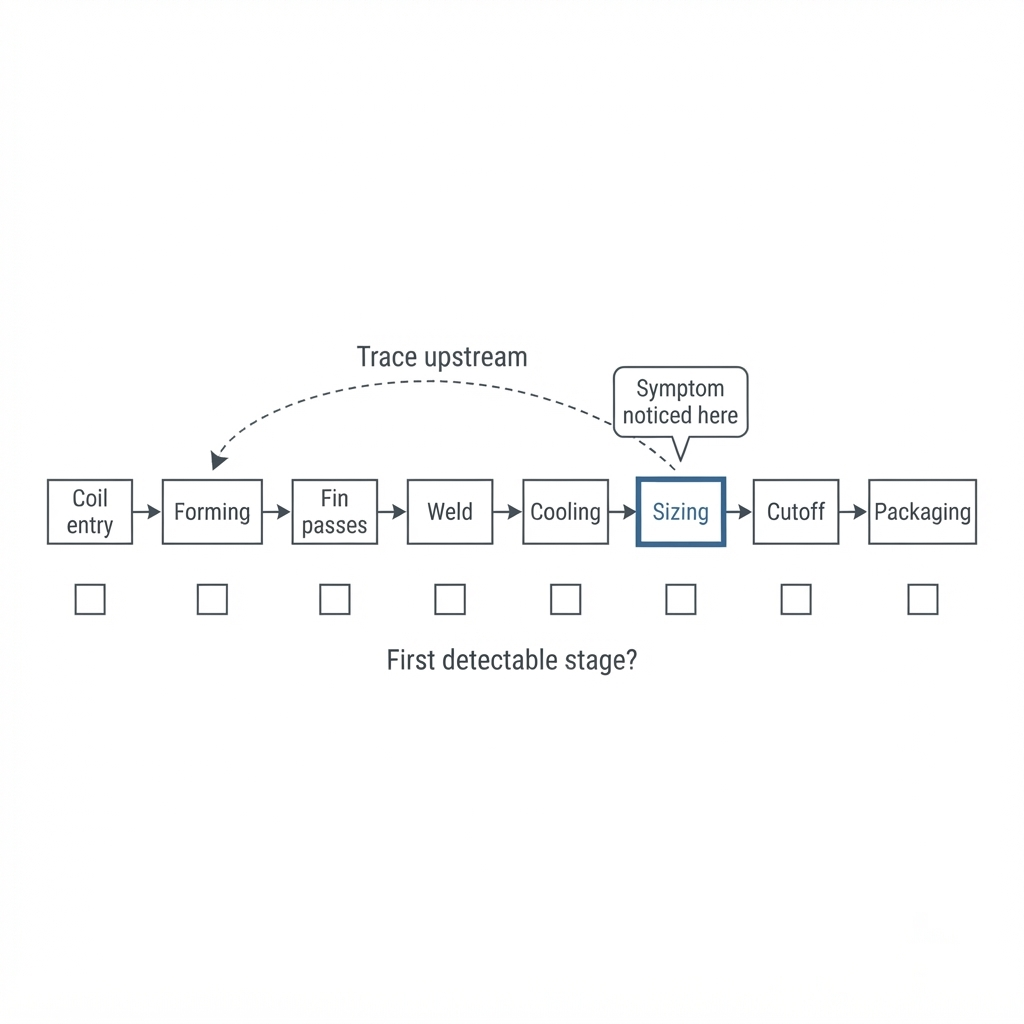

Process-flow diagram of eight tube mill stages from coil entry to packaging, each with a first-detectable-stage checkbox, with the sizing stage tagged as where the symptom was noticed and a dashed arrow tracing upstream toward forming

Place the first-detectable-stage question beside every production stage, then trace upstream from where the symptom was noticed.

Separate startup scrap from running scrap

Startup loss

Investigate:

  • Material and tooling readiness
  • Staging and changeover sequence
  • Setup-chart accuracy
  • Differences between target and stable-running actual
  • Time spent searching, waiting, remeasuring, or correcting installation
  • First-piece requirements and approval timing
  • Whether a known-good setup corresponds to the current tooling geometry

Running loss

Investigate:

  • Process drift
  • Coil or material transition
  • Tooling movement or wear
  • Heat, speed, cooling, and load changes
  • Measurement-system changes
  • Alarms, maintenance, and operator interventions
  • Time pattern or periodicity

Reducing startup scrap may require changeover and setup standardization. Reducing running scrap may require better detection, maintenance, material control, or process monitoring. Combining them in one rate hides the difference.

Preserve the run context

Every material loss event should link, at minimum, to:

  • Run/job and product revision
  • Material coil, heat, or lot
  • Tooling set and regrind state
  • Mill and setup revision
  • Timestamp or production interval
  • First detectable stage
  • Symptom and quantity
  • Disposition
  • Containment
  • Cause status

See the tube mill process control and digital setup records guide on this site for the complete model.

Prioritize recurring verified loss

A practical prioritization considers:

  • Total financial impact
  • Frequency
  • Severity and customer risk
  • Detectability
  • Production constraint
  • Recurrence across products or shifts
  • Confidence in the cause
  • Effort and risk of the proposed correction

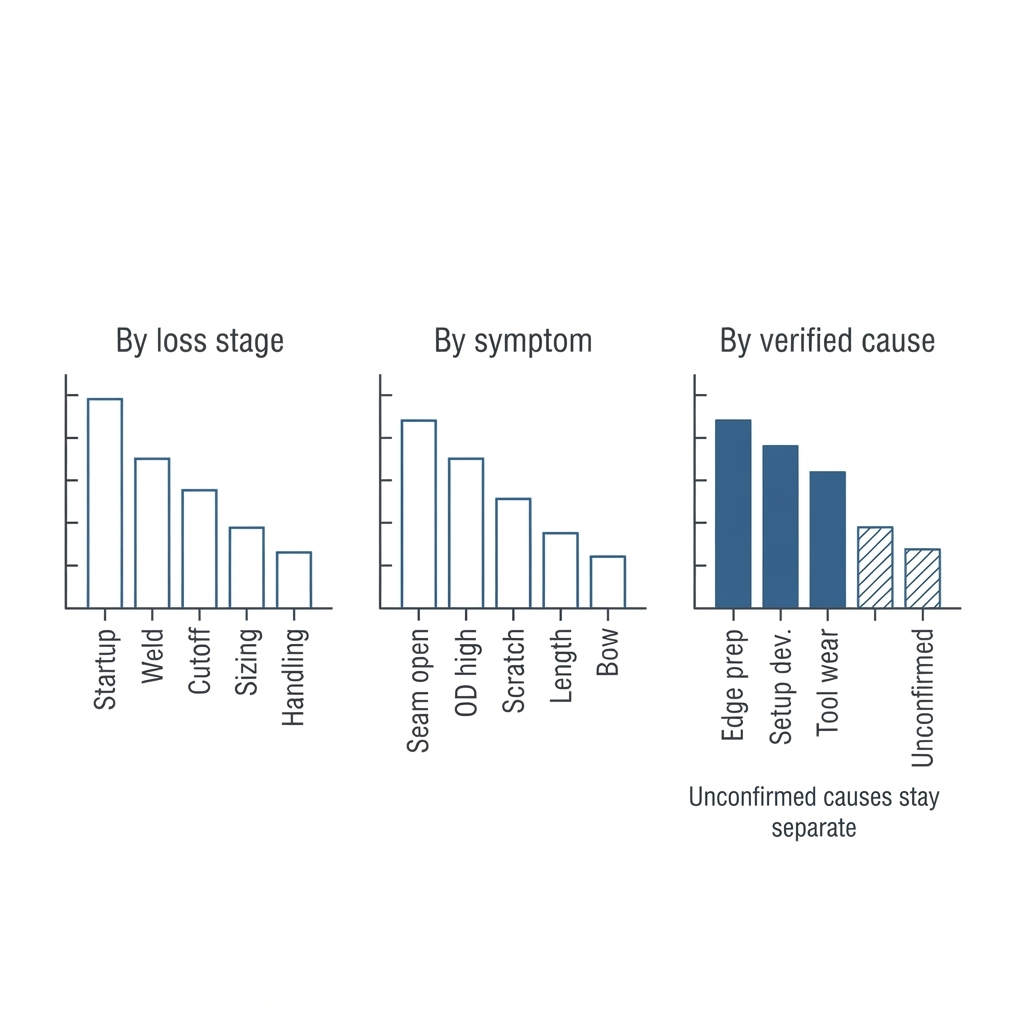

Three side-by-side fictional Pareto bar charts separating scrap by loss stage, by observed symptom, and by verified cause, with unconfirmed causes shown as hatched bars kept separate

Fictional example: separate Paretos for stage, symptom, and verified cause. Unconfirmed causes stay separate.

Do not prioritize only the largest isolated event if a smaller recurring loss reflects a systemic condition.

Validate the corrective action

A corrective action is not validated because the next piece passes. Define before implementation:

  • Expected mechanism
  • Response measure
  • Comparison baseline
  • Run length or sample
  • Affected product/material range
  • Unintended effects to monitor
  • Responsible reviewer
  • Criteria for adopting, revising, or rejecting the change

Preserve both before and after states. If several variables change simultaneously, label the result as a package change rather than claiming that one element caused the improvement.

Protect quality and safety

Scrap reduction must not weaken:

  • Containment
  • First-piece approval
  • Required destructive or nondestructive tests
  • Traceability
  • Calibration and measurement rules
  • Guarding or lockout/tagout
  • Qualified-person boundaries
  • Customer approval requirements

Material saved by bypassing a quality gate is not scrap reduction.

Safety boundary: Tube-mill investigation and maintenance must follow site lockout/tagout, guarding, stored-energy, electrical, pinch-point, hot-work, lifting, and qualified-person procedures. Never inspect, measure, clean, thread, or adjust moving equipment unless an approved procedure explicitly permits the task and provides the required safeguarding.

Recommended dashboard

  • Total loss by stage, symptom, and verified cause
  • Startup versus running loss
  • Weight, length, pieces, and financial impact
  • Time to first good piece
  • Loss by product, material lot, tooling revision, and setup revision
  • Unknown-cause loss aging
  • Recurrence after corrective action
  • Cost of containment and rework
  • Percentage of loss events with complete identity links

Dashboards should allow investigators to reach the underlying evidence rather than stopping at a chart.
